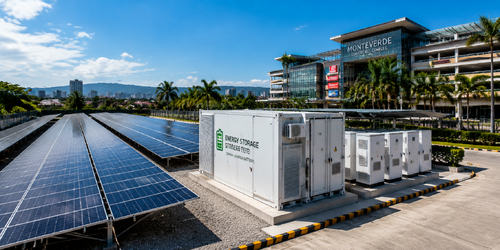

Solar Battery Storage Case Study: 151kWp PV + 200kWh BESS Cuts Grid Reliance 64% at Cebu Commercial Complex

News Details

In April 2025, a 150kWp solar photovoltaic system integrated with a 200kWh lithium iron phosphate battery energy storage system was commissioned at the Monteverde Commercial Complex in Cebu City, Philippines. The project was designed and deployed for Greenpeak Development Corporation, a mid-tier commercial property operator managing five retail and office assets across the Visayas region. After 14 months of continuous operation, the hybrid solar-plus-storage installation has reduced the complex's grid electricity consumption by 64% and eliminated an average of 4.2 hours of daily outage-related downtime that previously disrupted tenant operations across 38 retail units, three restaurants, and two office floors.

Project Background: Why Storage Became Mandatory

Greenpeak Development Corporation operates the Monteverde Complex, a 12,500-square-meter mixed-use facility housing retail outlets, food and beverage tenants, and professional office spaces. The building's baseline electricity consumption averaged 8,400 kWh per day, driven primarily by centralized air conditioning, commercial refrigeration, lighting, and IT infrastructure across 43 tenant units.

The Philippines' Visayas grid, managed by the National Grid Corporation of the Philippines, experienced chronic voltage instability throughout 2023 and 2024. According to data from the Independent Electricity Market Operator of the Philippines, the Cebu-Mactan corridor recorded an average of 11.7 unscheduled power interruptions per month in 2024, with individual outage durations ranging from 25 minutes to 6 hours. The longest single event in August 2024 blacked out portions of Cebu City for 8.3 hours. For Monteverde, each hour of downtime translated to an estimated PHP 42,000 in lost revenue and spoiled inventory, with food tenants bearing the heaviest losses.

Greenpeak initially explored a solar-only installation in late 2023. However, the net metering program administered by the Energy Regulatory Commission and local distribution utility Visayan Electric Company imposed a 100kWp export cap for commercial customers in their tariff class. This meant surplus daytime generation could not be fully monetized through grid export. Simultaneously, the complex's peak demand period ran from 14:00 to 19:00, overlapping only partially with solar generation hours that peaked between 10:00 and 14:00. A solar-only system would address roughly 40% of daily consumption but leave the critical late-afternoon and evening peak wholly dependent on an unreliable grid. Battery storage was not optional; it was the only configuration that made financial and operational sense.

System Architecture and Component Selection

The project team evaluated three configuration pathways before settling on the final architecture: a DC-coupled system with a single hybrid inverter, an AC-coupled retrofit with separate PV and battery inverters, and a fully integrated DC-coupled design with distributed power conversion. The third option was selected for its higher round-trip efficiency and simplified single-point grid interconnection.

Solar PV Array

A ground-mounted solar array was installed on a 980-square-meter unused parking extension on the building's south side. The array comprises 340 monocrystalline PERC modules rated at 445Wp each, supplied by a Tier-1 manufacturer with production facilities in Jiangsu, China. Modules are arranged in 17 strings of 20 panels each, delivering a total installed DC capacity of 151.3kWp. The mounting structure uses hot-dip galvanized steel with a fixed 12-degree tilt optimized for Cebu's latitude of 10.3 degrees north. Wind load calculations conformed to the National Structural Code of the Philippines, with the structure rated for 250 km/h typhoon-level gusts following the reinforcement lessons from Typhoon Odette in 2021.

Battery Energy Storage System

The battery storage system consists of four 51.2V nominal battery modules connected in series-parallel configuration, delivering a total nameplate capacity of 200kWh at 204.8V DC. Each module is a 16S LiFePO4 rack-mounted unit with a rated capacity of 50kWh, manufactured with prismatic cells rated for 6,000 cycles at 80% depth of discharge at 25 degrees Celsius ambient temperature under 0.5C charge and discharge rates. The actual usable capacity is configured at 180kWh, representing a 90% depth of discharge limit enforced by the battery management system to preserve cycle life. Cell-level monitoring tracks individual voltages with a measurement accuracy of plus or minus 5mV, and inter-cell voltage deviation is maintained below 30mV under all operating conditions through passive balancing at 100mA per cell.

Thermal management relies on forced-air convection with four temperature-controlled DC fans per module cabinet. The battery enclosure carries an IP54 rating, with the modules housed in a modified 20-foot shipping container retrofitted with insulation panels, an HVAC split unit maintaining internal temperature between 22 and 28 degrees Celsius year-round, smoke detection, and a clean-agent fire suppression system using Novec 1230. The container is positioned on a concrete pad adjacent to the solar array, with interconnecting DC cables run through buried PVC conduits at 600mm depth.

Power Conversion and Control Systems

The power conversion system is built around two 80kW hybrid inverters operating in parallel, each with a maximum DC input voltage of 1,000V and a rated AC output of 80kW at 400V three-phase. The inverters support four independent maximum power point tracking channels, with two channels assigned to the PV array and two channels dedicated to battery charge and discharge control. The units synchronize via a high-speed CAN bus running at 500 kbps, with a master-slave configuration that enables seamless failover if either unit goes offline.

The energy management system runs on an industrial-grade embedded controller with a 1.2GHz ARM processor, 2GB RAM, and 32GB solid-state storage. The EMS software implements a time-of-use optimization algorithm that ingests 15-minute interval data from a bidirectional meter at the grid connection point, real-time solar irradiance readings from two pyranometers at 5-second sampling intervals, battery state-of-charge from the BMS via Modbus TCP at 1-second polling, and building load data from 12 sub-metering points. The control logic issues charge and discharge commands with a 10-second control loop cycle, targeting three operational objectives in priority order: self-consumption maximization, peak demand shaving to maintain grid import below a 65kW contractual threshold, and time-shifting of surplus solar energy to cover the 17:00 to 20:00 evening peak.

The battery management system operates at three hierarchical levels. Cell-level monitoring boards sample voltage and temperature on each prismatic cell at 200ms intervals. A module-level BMS controller aggregates data from 16 cell boards and enforces protection thresholds including over-voltage at 3.65V per cell, under-voltage at 2.50V per cell, over-temperature at 60 degrees Celsius, and under-temperature charge lockout at 0 degrees Celsius. The system-level BMS master communicates with the EMS and inverter via Modbus TCP and dry-contact digital outputs for emergency shutdown signaling.

System Configuration Summary
Solar PV: 340 * 445Wp monocrystalline PERC modules = 151.3kWp DC
Battery Storage: 4 * 50kWh LiFePO4 rack modules = 200kWh nameplate, 180kWh usable
Power Conversion: 2 * 80kW hybrid inverters, parallel configuration
Controls: Integrated EMS, 3-level BMS, Modbus TCP + CAN bus communication
Container: Modified 20ft ISO container with HVAC, fire suppression, IP54 rating
Installation and Commissioning Timeline

Civil works commenced on January 6, 2025, with site clearing, foundation excavation, and concrete pouring for the solar mounting structure and the battery container pad. The solar array's 180 foundation piles were driven to a depth of 1.8 meters, with soil compaction testing confirming a bearing capacity exceeding 150 kPa at all pile locations. Concrete curing required 14 days due to Cebu's average humidity of 82% in January, slightly extending the schedule from the originally planned 10 days.

Module installation began on February 3 and was completed in 11 working days by a team of six installers and one supervising engineer. The battery container was delivered from the Port of Cebu on February 8 via low-bed trailer with police escort for the 14-kilometer overland route, which included two bridges with load restrictions that had been pre-cleared with the Department of Public Works and Highways. Container offloading used a 50-ton mobile crane, with positioning accuracy verified by laser level to within 5mm across the pad's four corner points.

Electrical integration, including DC cabling, AC switchgear installation, and control wiring, took 18 working days. The most time-consuming single task was the installation of a new 400A grid interconnection breaker in the building's main switch room, which required a scheduled 8-hour building-wide power shutdown coordinated with all 43 tenants three weeks in advance. Commissioning began on March 18 and consisted of a structured 120-point test protocol covering insulation resistance measurements on all DC strings at 1,000V, inverter synchronization and load-sharing verification, battery charge and discharge cycling at 0.2C, 0.5C, and 1.0C rates, EMS control logic validation across 48 simulated grid and load scenarios, and a 72-hour unattended reliability run at full system capacity.

One significant issue emerged during battery commissioning: two of the four battery modules exhibited a state-of-charge imbalance of 7.2% after the first full discharge cycle, traced to a firmware discrepancy in the slave BMS boards that had shipped with different calibration offset values. The manufacturer's remote support team pushed a firmware update via the EMS cloud interface on March 22, and the imbalance was reduced to below 1.5% after a single equalization charge cycle. No hardware replacements were required. The system was formally handed over on April 2, 2025, 12 days behind the original schedule due to the concrete curing extension and the BMS firmware correction.

PhaseStart DateDurationKey Milestone
Civil WorksJan 6, 202518 daysFoundation piles driven, concrete poured
Module InstallationFeb 3, 202511 days340 modules mounted and wired
Battery Container DeliveryFeb 8, 20251 dayContainer placed and leveled
Electrical IntegrationFeb 14, 202518 daysDC/AC cabling, switchgear, controls
CommissioningMar 18, 202515 daysFull test protocol, BMS firmware fix
HandoverApr 2, 20251 daySystem accepted, training completed
Operational Performance: 14-Month Data

Performance data was extracted from the EMS historian database covering the period from April 2, 2025, through June 1, 2026. During these 14 months, the system logged a total of 426 operational days, with 3 days of planned downtime for semi-annual preventive maintenance and 2 days of unplanned downtime related to a grid-side voltage surge on September 17, 2025, that triggered the inverter's anti-islanding protection and required a manual reset by the on-site technician. Overall system availability was calculated at 98.8%.

Solar generation averaged 642 kWh per day, with monthly averages ranging from 521 kWh per day in December during the northeast monsoon season with increased cloud cover, to 718 kWh per day in May during the dry season. Total solar generation over 14 months was approximately 273,500 kWh. The battery system cycled an average of 142 kWh per day, equivalent to 0.79 full equivalent cycles per day at the 180kWh usable capacity. Battery round-trip efficiency, measured as DC energy discharged divided by DC energy charged over each complete cycle, averaged 94.8% across all cycles, consistent with the manufacturer's specification of 95% plus or minus 1.5% at 0.5C average rate.

Grid electricity imports were reduced from the pre-installation baseline of 8,400 kWh per day to an average of 3,024 kWh per day, representing a 64% reduction. The complex's peak demand measured at the grid connection point dropped from 142kW to 57kW, comfortably below the 65kW contractual threshold and eliminating monthly demand charge penalties that had averaged PHP 18,500 prior to the installation. The self-consumption ratio, defined as solar energy consumed on-site divided by total solar generation, was 91.2%, with the remaining 8.8% exported to the grid under the net metering program at a feed-in tariff of PHP 5.68 per kWh.

Performance MetricPre-InstallationPost-InstallationChange
Daily Grid Consumption8,400 kWh3,024 kWh-64%
Peak Grid Demand142 kW57 kW-59.9%
Daily Outage Downtime4.2 hours0.05 hours-98.8%
Monthly Electricity BillPHP 2,184,000PHP 786,000-64%
Tenant Power Complaints/Month342-94.1%
CO2 Emissions (t/year)1,867672-64%
Financial Analysis and Observed Payback

The total project capital expenditure was PHP 18,200,000, equivalent to approximately USD 324,000 at the prevailing exchange rate in early 2025. This figure includes all equipment procurement, shipping and import duties, civil works, installation labor, commissioning, and a 5% contingency that was partially consumed by the extended concrete curing period and the BMS firmware remediation. The Philippine Board of Investments granted a 7-year income tax holiday on the renewable energy component under the Corporate Recovery and Tax Incentives for Enterprises Act, applying to 72% of the project value attributable to solar generation equipment.

Monthly electricity cost savings averaged PHP 1,398,000 over the first 14 months, comprising PHP 1,162,000 in reduced kWh consumption charges, PHP 127,000 in eliminated demand charge penalties, and PHP 109,000 in net metering export credits. Against this, the system incurs approximately PHP 38,000 per month in operating expenses covering the preventive maintenance contract with the local EPC partner, HVAC power consumption for the battery container, EMS cloud subscription fees, and a small allocation for inverter air-filter replacements and general consumables. Net monthly savings therefore average PHP 1,360,000.

At this net savings rate, the simple payback period is projected at 13.4 months from commissioning, or approximately 14.6 months accounting for the 2-month construction period during which the system generated no savings. The levelized cost of stored energy, calculated as the total system cost divided by the total kWh discharged from the battery over a 10-year assumed service life with a 5% annual discount rate, is PHP 6.82 per kWh. This compares favorably against the grid's average commercial tariff of PHP 11.45 per kWh and the diesel generator backup cost of PHP 28.40 per kWh that the complex previously relied upon during outages.

Customer Feedback and Operational Experience

In a structured interview conducted in May 2026, the facility manager of Monteverde Complex, Mr. Ramon Aguilar, provided candid feedback on the system's first 14 months. His observations, presented verbatim below, offer practical insight into the day-to-day experience of operating a commercial solar-plus-storage system in a tropical urban environment.

"The single biggest change is that we no longer think about power," Aguilar stated. "Before this system, every morning started with me checking the Visayan Electric load shedding schedule on my phone. If there was a 3-hour outage scheduled between 14:00 and 17:00, I had to call every restaurant tenant to warn them, and at least one would lose a refrigerator full of inventory anyway. That mental load is completely gone now. The battery covers every outage automatically. The tenants don't even notice."

On maintenance, Aguilar reported that the semi-annual HVAC filter replacement and inverter inspection have been the only recurring tasks. "The first time the technician opened the inverter cabinet for the 6-month check, he found a gecko nest inside the cable gland. That was not in the manual," he noted. "We've since installed fine mesh screens over all enclosure openings. I would recommend that detail to anyone installing this equipment in Southeast Asia."

Regarding tenant satisfaction, the complex's annual tenant survey showed net promoter scores from food and beverage tenants improved from 42 to 78 between 2024 and 2026, with "power reliability" cited as the top factor in written comments. One restaurant operator reported a 22% reduction in food spoilage costs, directly attributed to the elimination of refrigeration outages.

Aguilar identified two areas for future improvement. First, the EMS user interface, while fully functional for engineers, required approximately 12 hours of training before he felt comfortable interpreting the battery state-of-health trends independently. A simplified dashboard view for non-engineering facility staff would reduce reliance on the EPC partner's remote support. Second, the system's mobile app notifications for grid outages have a latency of 45 to 90 seconds due to cloud-server polling intervals, which Aguilar described as "acceptable but not ideal" for a facility manager who prefers to know about outages in real time.

Lessons Learned and Replicability

Several engineering and planning insights emerged from this project that are relevant for similar commercial solar-plus-storage deployments in tropical developing markets.

First, the concrete curing delay in high-humidity conditions should be factored into project schedules as a standard buffer rather than treated as a risk contingency. In Cebu's January climate, the 14-day curing period was predictable rather than exceptional. Future projects in similar environments should baseline 15 days for foundation concrete work rather than the 10 days commonly assumed in template project plans derived from temperate-climate experience.

Second, BMS firmware version control proved to be the single point of failure that could have been prevented with a mandatory pre-shipment acceptance test including a full charge-discharge cycle across all modules in their as-shipped configuration. The 5-day delay for firmware remediation was avoidable. Including a pre-shipment integration test clause in the equipment supply contract would add approximately 3 days to the procurement timeline but eliminate the risk of on-site firmware mismatches.

Third, the gecko ingress incident highlights the need for regionalized enclosure design. While the inverters and battery modules carry IP54 or higher ratings, cable gland openings, ventilation louvers, and communication port covers represent entry points for small fauna common in Southeast Asian industrial environments. A retrofit mesh screen kit costing approximately PHP 8,500 across the entire installation prevented what could have become a recurring maintenance issue.

Fourth, the 100kWp net metering export cap imposed by the local distribution utility was a binding constraint that shaped the entire system design. Other commercial customers in the Visayan Electric franchise area considering solar-plus-storage should verify their applicable export limits during the feasibility study phase, as these limits directly determine the optimal ratio of PV capacity to battery capacity. In this project, the 151.3kWp DC array was deliberately oversized relative to the 100kWp export cap because the battery could absorb the surplus, converting what would have been curtailed generation into stored energy for evening dispatch.

Future Expansion Plans

Based on the positive operational results, Greenpeak Development Corporation has initiated a feasibility study for a 300kWh battery capacity expansion at Monteverde, which would increase total storage to 500kWh and extend backup autonomy from the current 3.2 hours at full load to approximately 8 hours. The expansion would use the same LiFePO4 module platform, leveraging the existing container's spare rack positions and the inverters' spare DC input capacity. Preliminary cost estimates suggest an incremental investment of PHP 6,400,000, with a marginal payback period of approximately 2.1 years based on the avoided cost of a planned diesel generator replacement that the expansion would render unnecessary.

Additionally, Greenpeak is evaluating the Monteverde configuration as a reference design for replication across its four other commercial properties, with a combined pipeline potential of 600kWp solar PV and 800kWh battery storage across the portfolio. A group procurement strategy is under consideration to capture volume discounts on both module and battery pricing.

This case study is based on operational data from the Monteverde Commercial Complex installation in Cebu City, Philippines. System performance metrics cover the period April 2025 through May 2026. All financial figures are denominated in Philippine Pesos at 2025 constant values. For technical inquiries regarding similar commercial solar-plus-storage deployments, please contact our engineering team.
